Costs and Benefits can be …

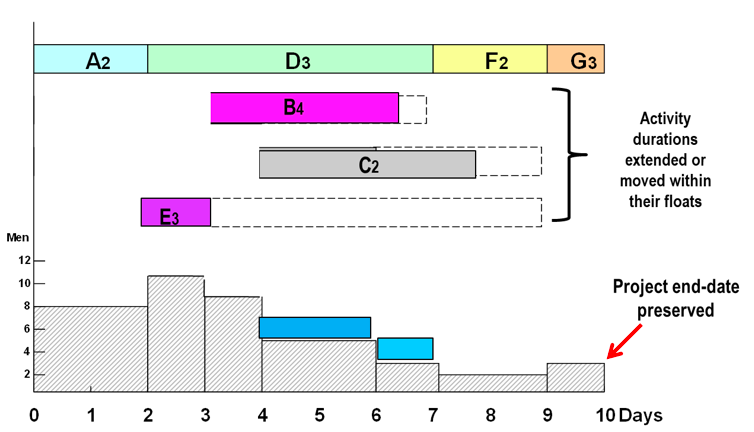

In scheduling, what is smoothing?
When resources over the period of a project are highly irregular:

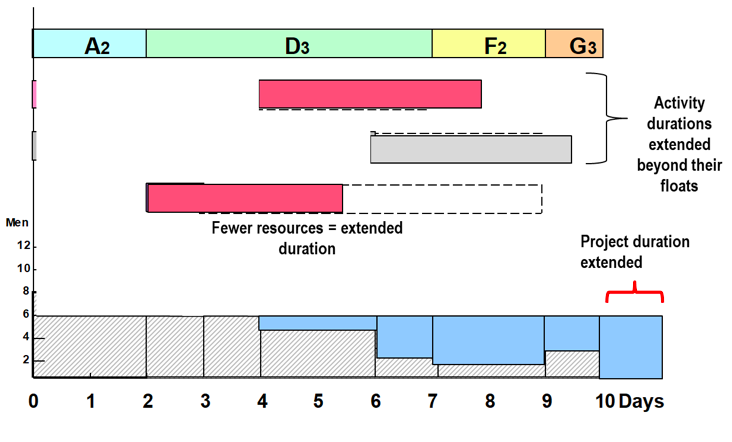

In scheduling, what is levelling?
When resource constraints force you to reschedule items

What is the Systems Design Lifecycle + 8 phases
a phased cycle
typical accumulative resource demand (on a graph)
an ‘S curve’
What is resource management?
resource planning:
3 categories of resources
How to establish a budget?

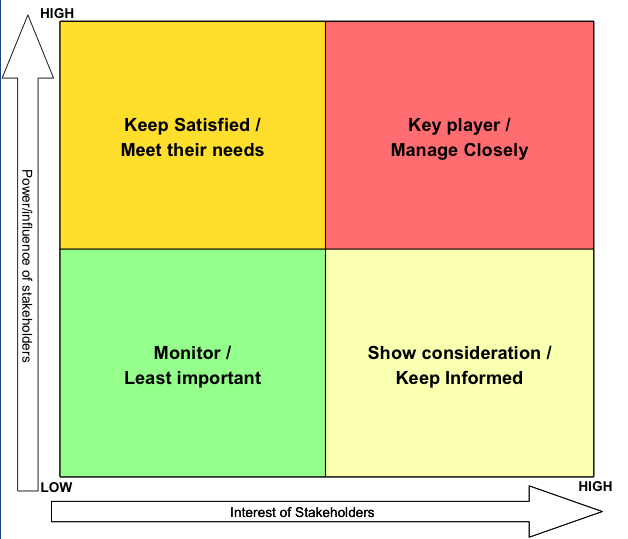

Draw the Stakeholder Analysis Matrix
and why move people to the right side?
Yellow Box People
Green Box People

Float Days
The amount of time (days) an activity can be delayed without affecting the project completion date.
The difference between the latest and earliest starting date:
LST - EST
Crash Actions
Fixing problems by adding more resources, e.g. hiring more people, or working longer…
but this might not be straightforward
Define Schedule diagrams
a visual representation of when things happen
good for managing expectations (for project and tasks scope)
gives people a high-leve idea of the prject
What are schedule dependencies?
shows which activities need to be in sequence and which can be done in parallel
activities that depend on another activity in order to begin

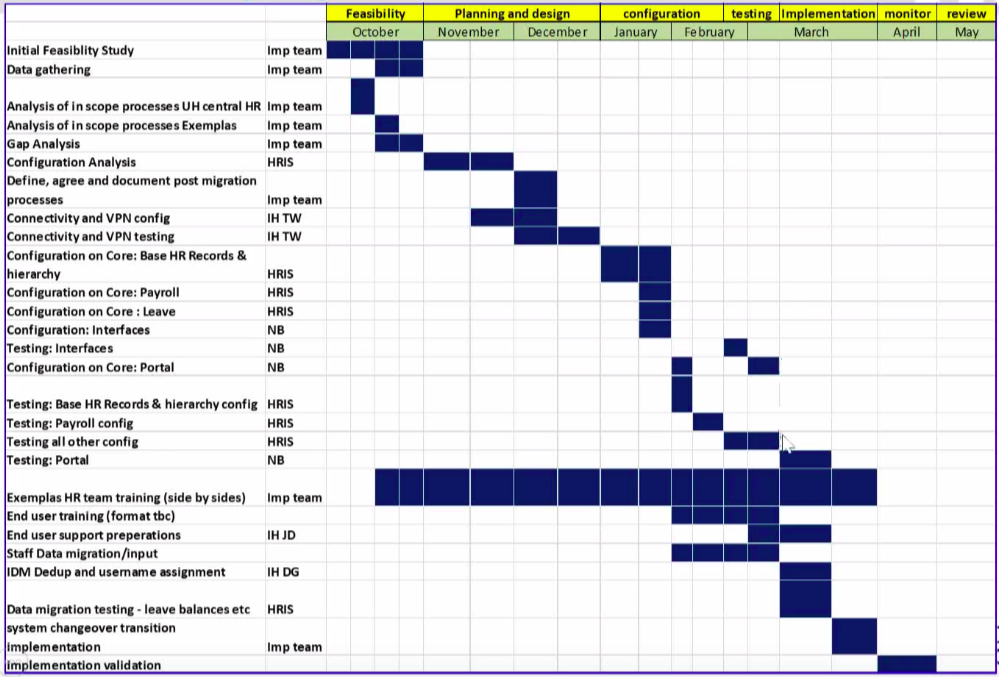

What is the Gantt Chart + advantages
a planning and communcation tool in form of a bar chart
planning: shows people their task and given time, and shows them the work that needs to be done beforehand
communication: may not give exact details but shows stakeholders what the project entails and what the overall high-level duration will be
Gantt Chart (visually) helps indentify milestones
acts as baseline for the future changes and deadlines

What is the critical path in scheduling?
The path in a network diagram that has no floats.
if there is a delay in any of the activities within the critical path, the overall project will be delayed
The critical path is the longest sequence of activities in a project plan which must be completed on time for the project to complete on due date. An activity on the critical path cannot be started until its predecessor activity is complete;
Benefits of scheduling
How can the project duration be calculated?
earliest start + earliest finish
something that is ongoing within a project is a …
overhead task
can be represented in a as a continues line in a bar chart
resource histograms
visualises the resources demand for a given time
useful for visual communication of levelling and smoothing
can be combined with a bar chart
Define Stakeholder Management
identifying, analysing, and planing the communication, negation, and influence of stakeholders
typical stakeholder roles in a simple IT project
Define a project
General PM Info

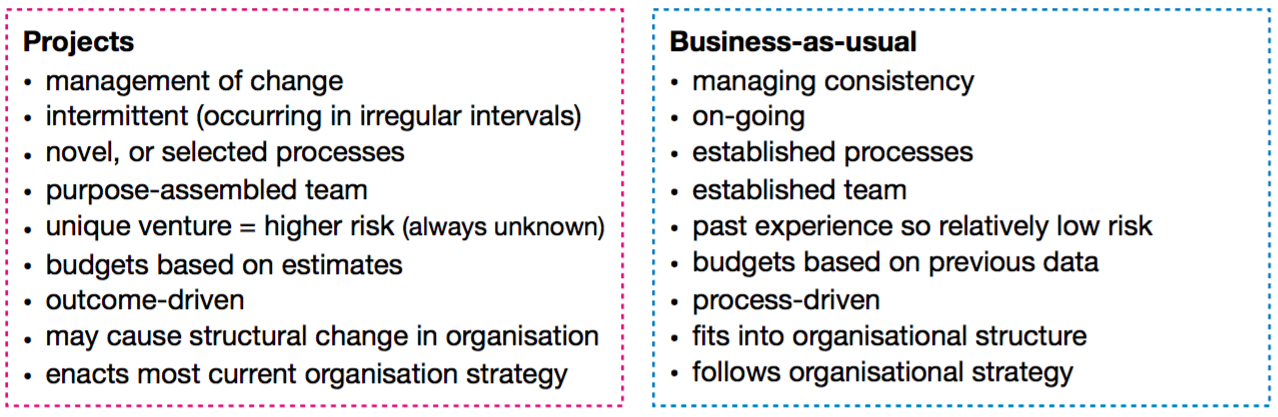

projects vs. business-as-usual
