what are the techniques associated with resource management?
what are the tools of resource estimation
subjective - guestimates based on experience
bottom-up - costs estimated in WBS then aggregated
comparative - based on similar projects parametric
what is bottom-up estimation and advantages/limitations?
practical problems in cost estimation
what is comparative estimation and advantages/limitations
what is parametric estimation and advantages/disadvantages?
cost = F(a,b,c,d,f)
+may reduce estimation process costs
what is resource allocation?
the process by which resources are mapped against activities
what are the stages in the resource allocation process?
what is resource loading?
evening out resource usage to avoid peaks and troughs
overloaded - resource requirements exceed capacity
underloaded - more capacity than work to do
what are the two types of resource allocation optimisation?
resource smoothing (time limited scheduling)
resource levelling (resource limited scheduling)

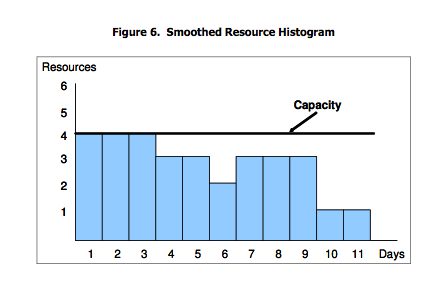

what is resource smoothing?

what is resource levelling?
adjusts the compltion time within a fixed resource limit
can include;
- extending or shortening task durations
- scheduling activities according to when resources are available
- focus is to optimise usage for each task through identifying resource underloads
what is stretching?
if a task takes 2 people 2 days, stretch to 4 days with 1 person
what is splitting?
if a task takes 2 people 4 days and the required persons are available 2 days this week and two days next, the task could be split over that period

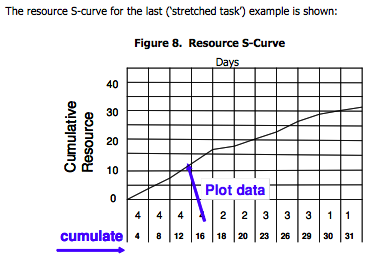

what is the S-curve?
cumulative labour budget for project

what is general order for re-scheduling tasks?
what is resource loading?

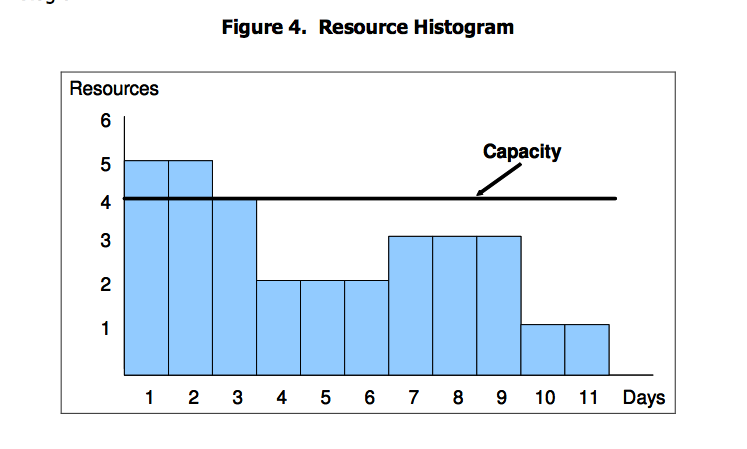

a measure of a resource’s usage over a period of time.
Shown on resource histogram
