what is the schedule
what is the process of scheduling?
what is a network?
what is float
float - the about of time by which non-critical activities can be delayed without affecting the project’s completion date
critical path
those activities which, if delayed, would delay the whole project activities on the critical path have zero float
AON networks
activity on node network activities are shown as (boxes) nodes which are connected, showing dependencies using arrows
Draw node format

How do you calculate duration of project?
How do you calculate float?

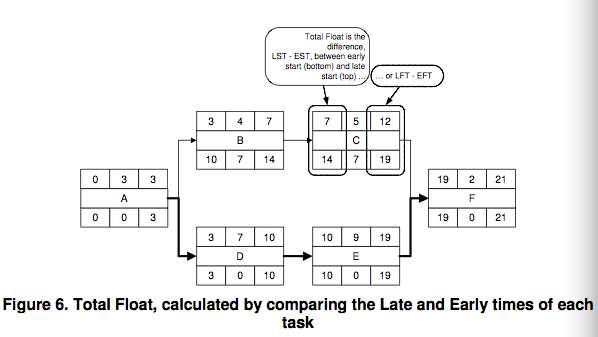

How do you calculate total float?
difference between the LST for an activity and its EST
i.e. - on node either the difference between first top and bottom or last top and bottom number

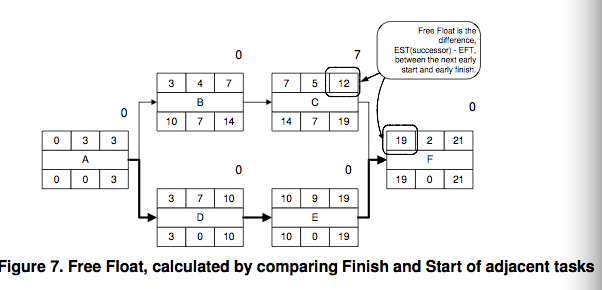

what is free float?
the amount of time by which an activity can be delayed without affecting the earliest start time of any sucessor activity
free float = EST (of earliest successor) - EFT
free float is denoted at the top right hand side of each node pic

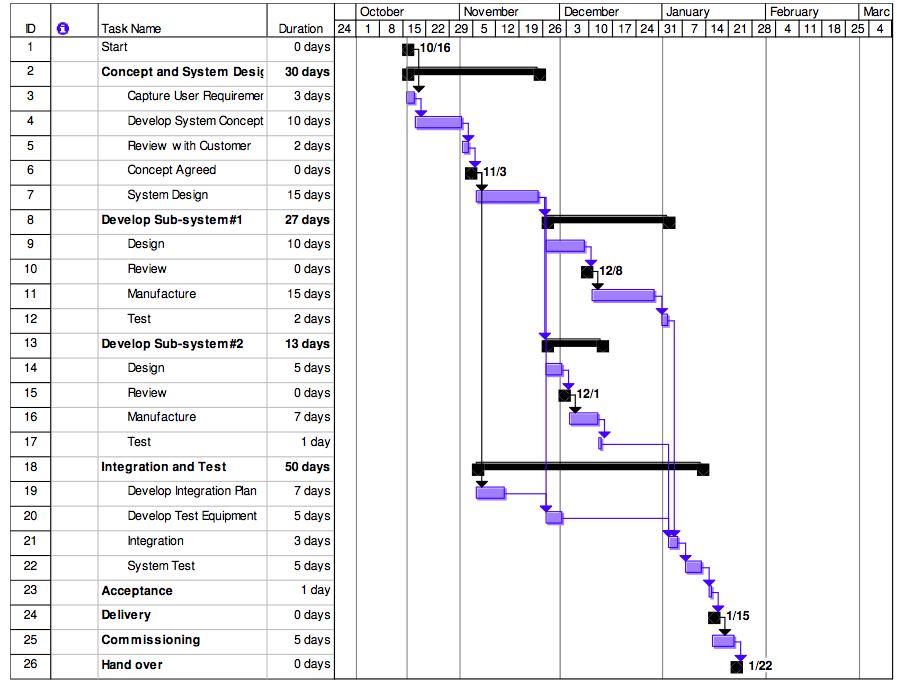

what is a gantt chart?
bar chart representation of the network
horizontal rows represent activities
task dependencies linked by arrows

advantages of gantt chart
disadvantages of gantt chart
dependencies not as apparent as in the network diagram can become confusing
What are lags?
what is crashing?
the reduction of the critical path, however there will be a cost associated with this.
(overtime labour, additional equipment)
schedule crashing considers the lowest cost option for reducing the critical path
*How do you do crashing analysis?
What criteria would you use for re-seceduling activities?
Cannot re-schedule tasks on the critical path – as this will adversely impact the project completion date.
• Tasks with free float first, tasks can be moved within their free float without adversely affecting the EST of successor activities.
• Tasks with total float next, as these can be moved without affecting the project completion date.
• Consider which tasks would cause least disruption or difficulty to re-schedule, for example – go for small, easy tasks first.
• The context of the network as a whole, aim to met the resource requirements but whilst retaining as much float as possible within the network.
